Field Services · Emergency Response · June 2023

230 kV Autotransformer
Emergency Replacement

A 230 kV transmission autotransformer suffered a catastrophic failure during the peak of Florida’s summer load season. Southern Switch mobilized the following morning, coordinating crane operations, removing the destroyed unit, transporting the replacement from the utility’s spare storage at a regional generating plant, completing the installation, and performing full apparatus testing before the unit returned to service.

01, The Failure

Worst time.
Worst unit to lose.

June in Florida is not a month when any utility can afford a transmission-class transformer out of service. Air conditioning load runs at its annual peak, grid margins are thin, and every MW of capacity counts. A 230 kV autotransformer is not a unit you bypass or work around, it is a critical node in the transmission network, and losing it strains capacity across the surrounding grid.

The unit suffered severe thermal damage. What remained on the pad was not a candidate for repair or refurbishment, the only path back to service was a replacement unit, moved and installed as fast as possible.

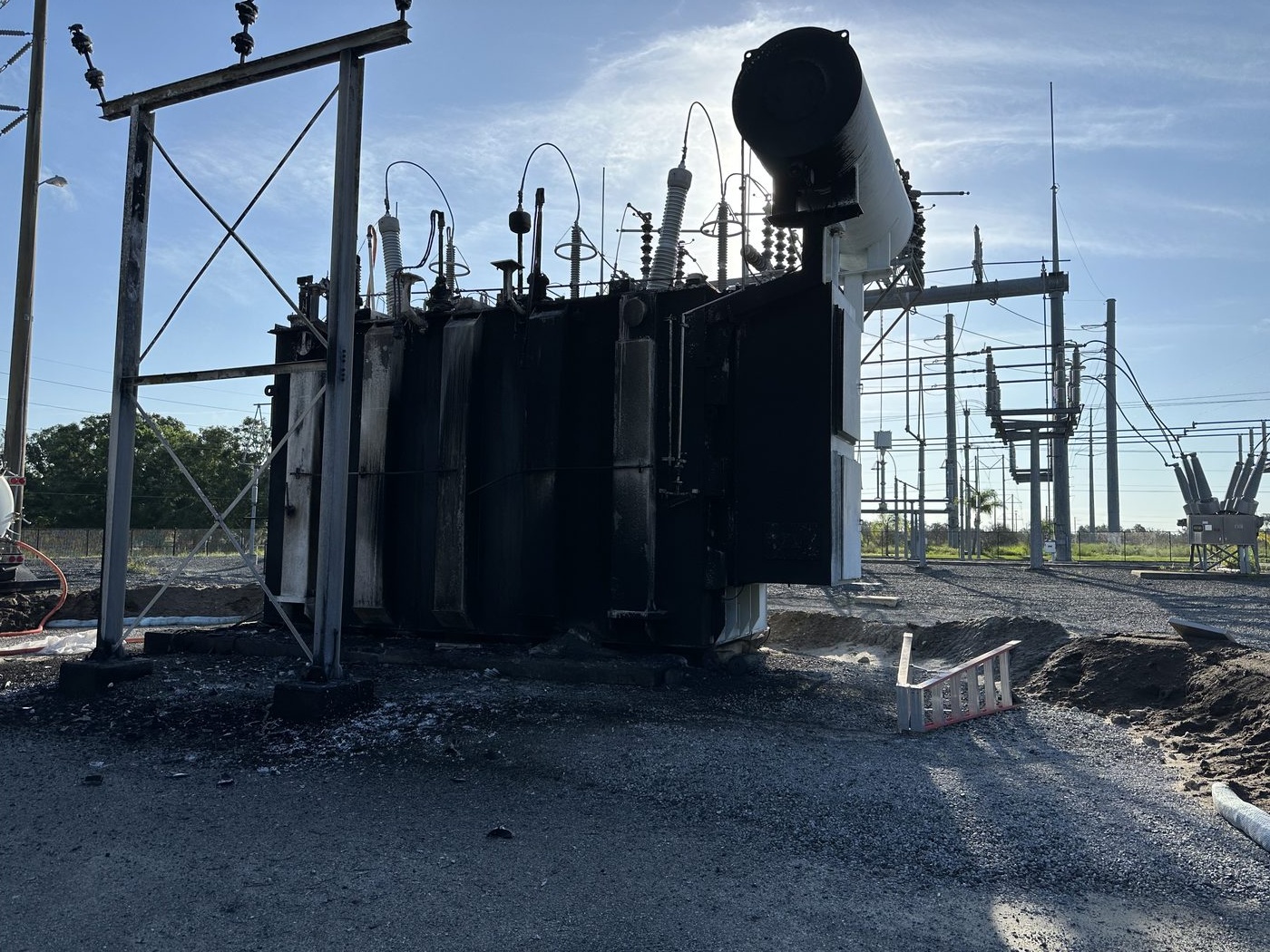

A 230 kV autotransformer after catastrophic thermal failure, severe fire damage to the tank and external components. Southern Switch was called in to remove the failed unit and install a replacement.
The failed unit The 230 kV autotransformer as Southern Switch found it. Severe thermal damage across the tank and external components. The unit was a total loss, removal and replacement was the only option.

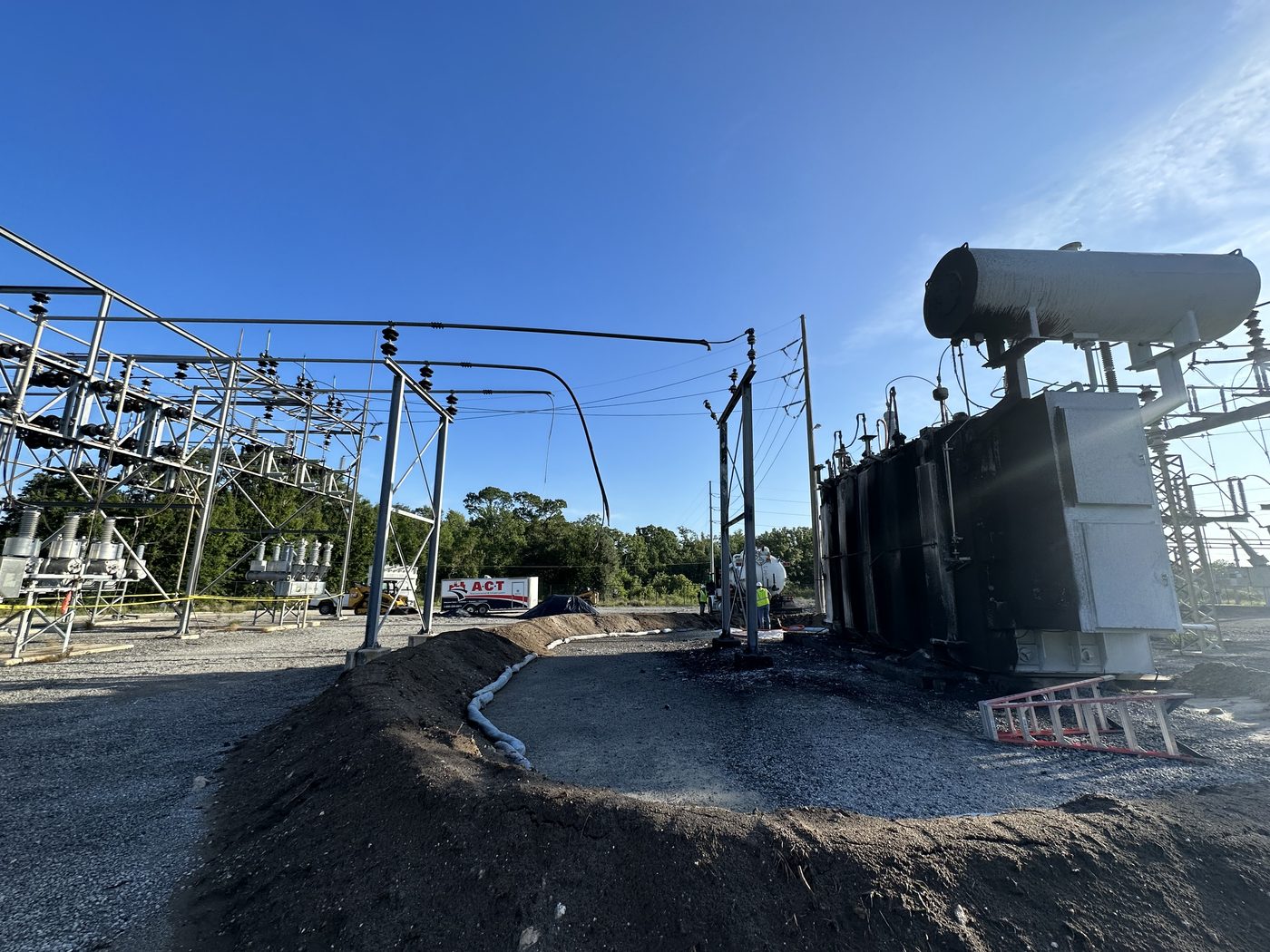

A 230 kV autotransformer failure site showing the replacement unit installed on the pad, scorched ground from the transformer fire, containment berms, and the bus structure that also required replacement.
Site damage, full scope The failure site with the replacement unit installed on the right. The scorched gravel and containment berms show where the transformer oil burned. The bus structure visible in the frame was also damaged in the failure and had to be replaced as part of the same operation, the transformer was not the only casualty.
230 kV
Transmission-class autotransformer
June
Florida peak cooling load season
Next day
Southern Switch mobilization

Not a swap,
a full teardown and rebuild.

The utility contacted Southern Switch following the failure. Southern Switch confirmed mobilization for the following morning. The scope was significant: a 230 kV autotransformer in spare storage doesn’t sit on a truck and drive to a new site. It has to be completely disassembled, bushings, conservator, radiators, all external components removed, transported, then fully reassembled and tested at the installation site before it can be energized.

The utility maintained the spare at a regional generating-plant storage facility. Southern Switch held the field services contract and coordinated the entire operation: crane subcontractor, disassembly at the storage site, transport to the failure site, removal of the failed unit, and reassembly and testing of the replacement.

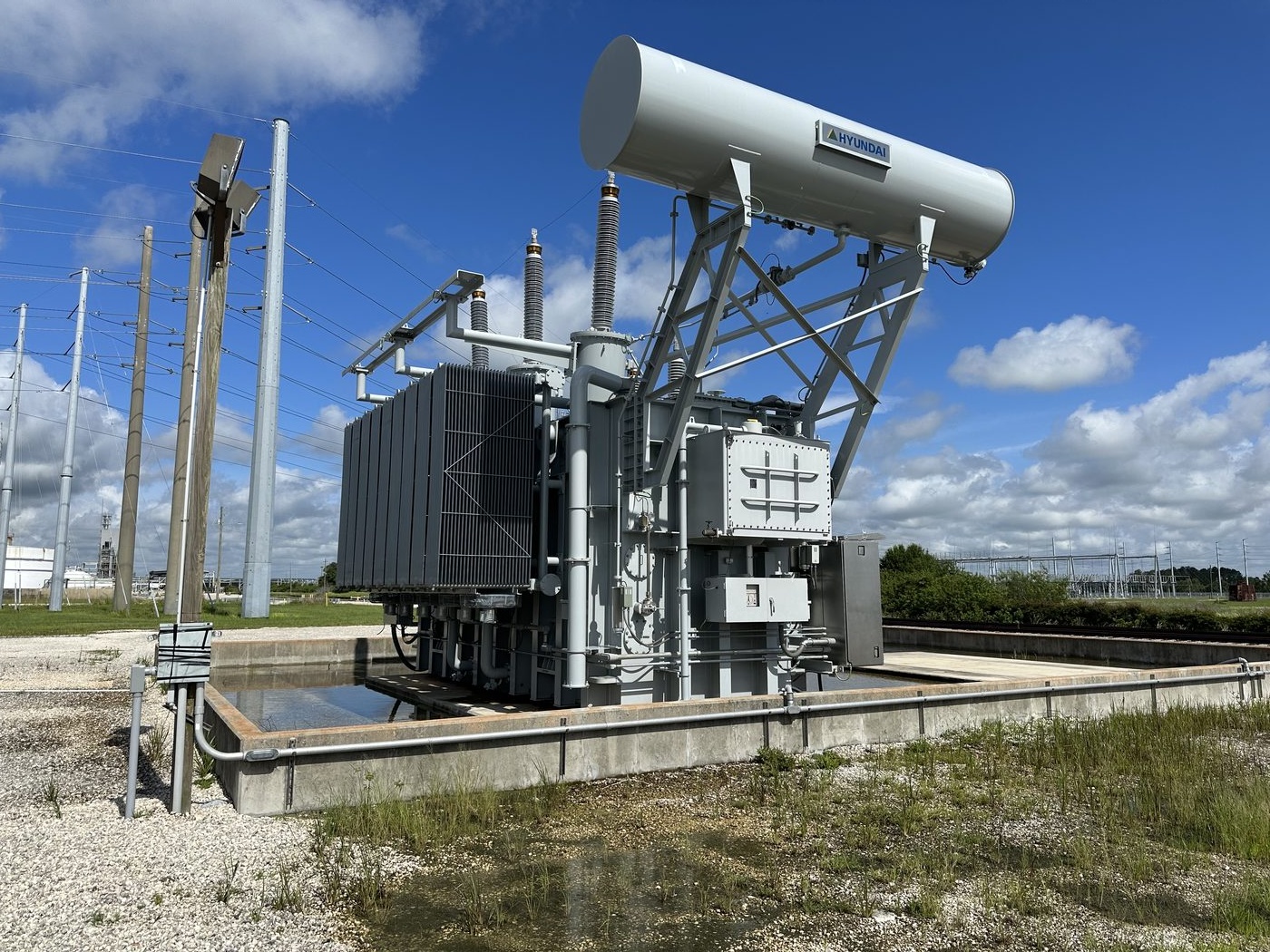

A 230 kV Hyundai autotransformer in spare storage at a regional generating plant before disassembly. The conservator tank and support frame are visible, these had to be removed before transport.
The spare in storage The replacement unit in storage before disassembly. The conservator tank and its support structure, bushings, and all external components had to be removed before the main tank could be transported. Everything was then reassembled at the installation site.
Southern Switch scope
  • Next-day field mobilization
  • Contracted and coordinated crane subcontractor for all lifts
  • Complete disassembly of spare unit at the storage site (bushings, conservator, radiators, external components)
  • Transported main tank and all components from the storage site to the installation site
  • Removed failed unit from its pad
  • Set and fully reassembled replacement autotransformer on the pad
  • Replaced damaged bus and one structure destroyed in the failure
  • Performed complete apparatus testing before the utility authorized energization
Why this scope matters

Most utilities keep a spare transformer for exactly this situation, but getting that spare from storage to service is not a simple crane pick. A 230 kV autotransformer travels as a main tank only. Bushings, the conservator and its steel support frame, radiators, oil preservation equipment, everything comes off before transport and goes back on at the destination.

That reassembly has to be correct before any test is run, and the tests have to pass before the unit goes back into a transmission circuit. Managing both, the physical rebuild and the test program, under time pressure is what Southern Switch delivered.

Testing the spare
before it goes live.

A transformer that has been in spare storage needs the same pre-energization test suite as a new installation. Storage conditions, humidity, temperature cycling, handling during transport, can all affect insulation condition. The tests below were performed on the replacement unit after installation and before the utility completed protection and control checkout and returned the unit to service.

Insulation Resistance & PI

Winding-to-ground and winding-to-winding megohm readings with polarization index. Flags moisture ingress from storage. Critical on any unit that has been sitting idle, insulation condition in storage is not guaranteed.

Turns Ratio (TTR)

Ratio tested at all tap positions against nameplate data. Confirms winding integrity and that handling and transport introduced no internal damage. For an autotransformer, ratio verification also confirms the series and common winding relationship.

Winding Resistance

DC resistance measured per winding and per phase. Phase-to-phase balance confirms no loose connections or contact degradation at the tap changer that may have developed in storage.

Excitation Current

No-load exciting current per phase. Core deformation from shipping or handling shows here. A transformer with a shifted or damaged core is not a unit you want in a 230 kV circuit.

Power Factor (Doble)

Capacitance and power factor on windings and bushings. Moisture in insulation shows in power factor before it shows in megohm readings. Elevated power factor on a spare unit coming out of storage is a finding that stops energization until the cause is understood.

Oil Sampling

Fluid samples taken for dielectric strength, moisture content, and dissolved gas analysis. A clean dissolved gas profile on a spare confirms the unit has not been experiencing internal heating, arcing, or partial discharge during storage.

Replacement tested
and returned to service.

The replacement unit passed apparatus testing. Southern Switch delivered the test data and documentation to the utility. The utility completed protection and control checkout and returned the 230 kV autotransformer to service, restoring transmission capacity during the peak of Florida’s summer load season.

The failed unit was removed from the pad and disposed of by the utility. What was left on the pad when Southern Switch arrived was a total loss. What was energized when the work was done was a tested, documented, serviceable transformer.

Transformer emergency?

Call (914) 582-9346, 24/7. We coordinate the crane, the transport, the installation, and the testing. You focus on switching and protection.
